Ho Chi Minh City

Sunday, June 15, 2025, 11:56 GMT+7

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline

The An Phu Intersection project in Ho Chi Minh City has only six months left to meet its scheduled completion by the end of 2025, but many components are still progressing slowly, with some areas nearly at a standstill.

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline

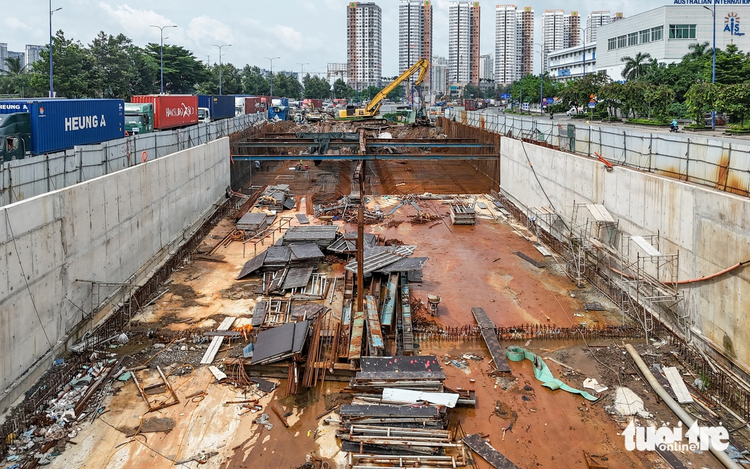

Luong Minh Phuc, director of the Transportation Works Construction Investment Project Management Authority of Ho Chi Minh City, stated that the reason package XL6 of the An Phu Intersection project in the city showed only a one-percent increase over nine months was due to a data error. Photo: Chau Tuan / Tuoi Tre

Large sections of the construction site remain quiet.

Some parts of the tunnel structure have been completed but continue to be fenced off.

The overpass section on Mai Chi Tho Avenue has seen little active construction, with scattered machinery on-site.

Meanwhile, several houses along Luong Dinh Cua Street have yet to be relocated.

Only a few small work crews are seen working with urgency, interspersed between inactive zones.

As of June, the overall project progress has reached some 68 percent, a 13-percent increase compared to September 2024.

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 1.

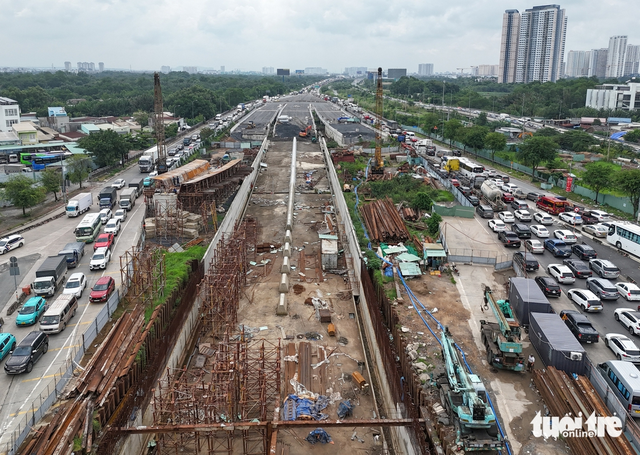

Package XL6 involves the construction of tunnel HC1-02, which connects the Ho Chi Minh City - Long Thanh - Dau Giay Expressway ramp to Mai Chi Tho Avenue in Ho Chi Minh City. Photo: Duc Phu / Tuoi Tre

Of note, package XL5, which includes tunnel HC1-01, has completed its structure and reached 85-percent progress.

However, the tunnel remains closed to traffic pending the completion of a drainage pumping station, causing the Transportation Works Construction Investment Project Management Authority of Ho Chi Minh City to adjust the traffic opening schedule multiple times.

A key point of concern has been package XL6, involving tunnel HC1-02, which was previously reported to have progressed by only one percent over nine months.

The Transportation Works Construction Investment Project Management Authority of Ho Chi Minh City later corrected this, attributing the figure to a data error.

Currently, package XL6 is 67 percent complete, with 17 out of 21 tunnel segments finalized.

The remaining four segments, along with the pumping station and lighting system, are expected to be accelerated from June.

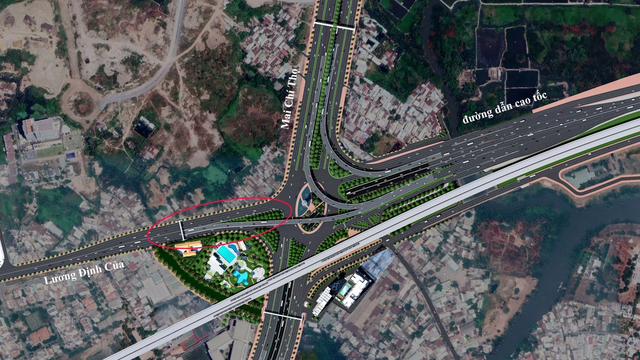

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 2.

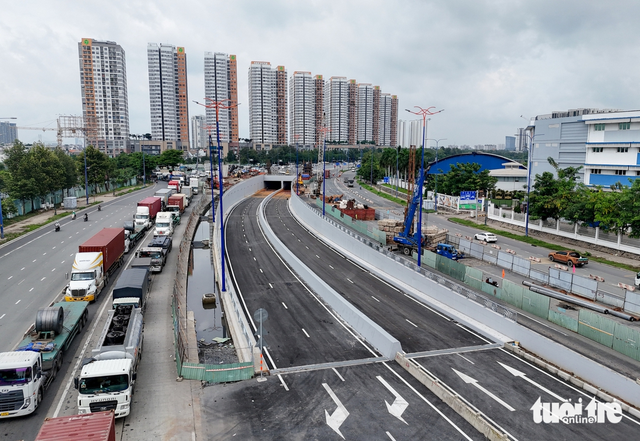

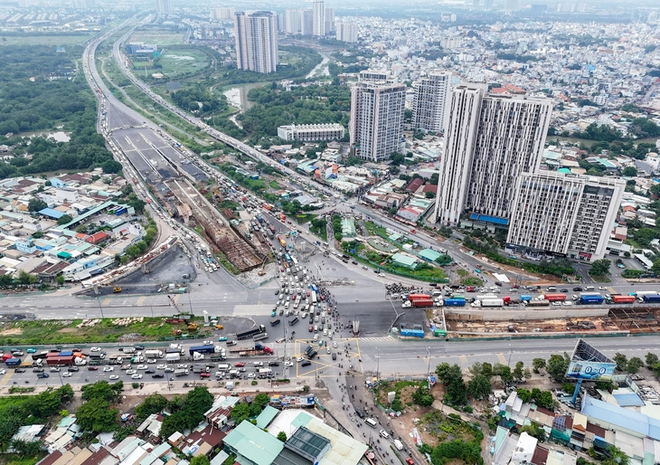

The open section of tunnel HC1-02 at the An Phu Intersection project in Ho Chi Minh City, as seen from above. Photo: Chau Tuan / Tuoi Tre

Meanwhile, several other packages continue to lag.

Packages XL12 and XL13 have only reached 11–15-percent completion.

XL12, which involves the construction of the second branch of the overpass connecting Mai Chi Tho Avenue and Luong Dinh Cua Street, saw just a five-percent rise over the past nine months.

The primary cause is a delay in site clearance, traffic diversion, and drainage work.

Notably, the overpass on Luong Dinh Cua Street has seen little progress due to pending land handover.

The project owner stated that beginning in July, when site clearance is completed and tunnel sections near completion, construction packages will accelerate.

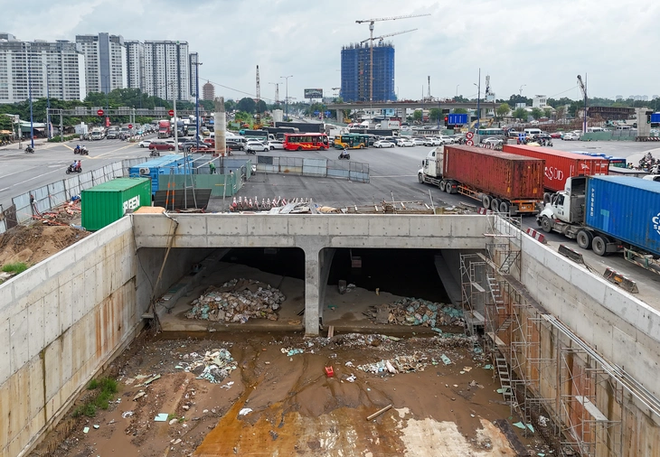

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 3.

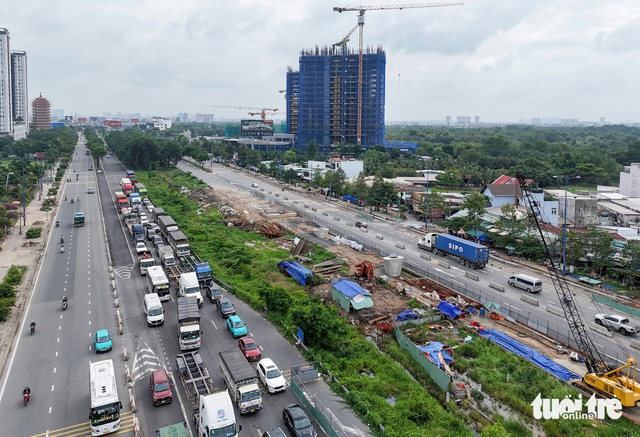

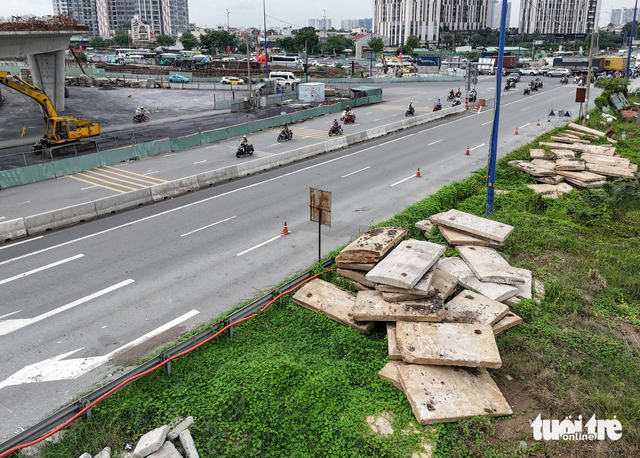

The Transportation Works Construction Investment Project Management Authority of Ho Chi Minh City noted that An Phu Intersection is a project that is being carried out while ensuring continuous traffic flow, with the vehicle volume in the area remaining very high. Photo: Duc Phu / Tuoi Tre

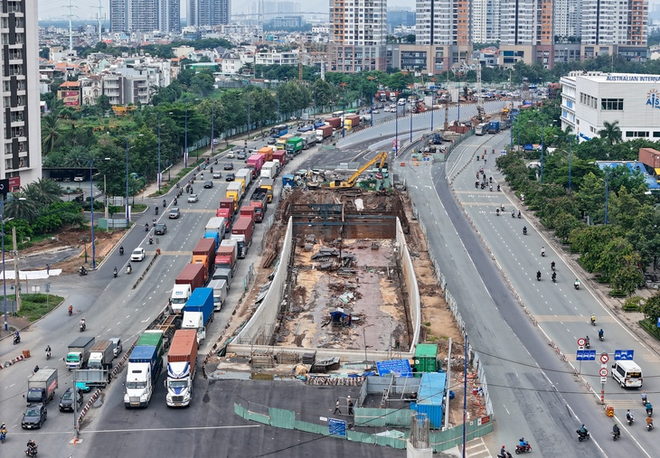

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 4.

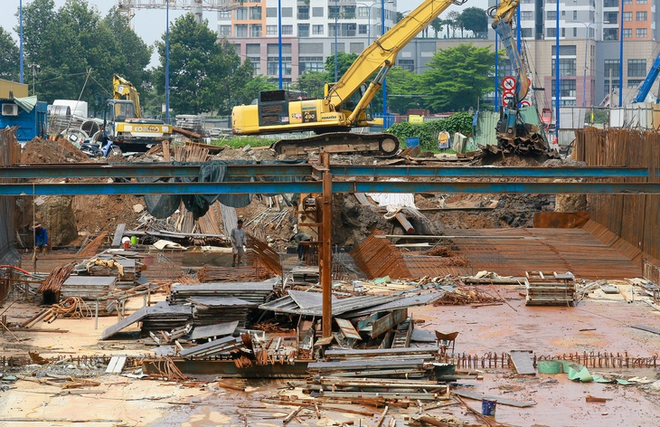

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 5.

A small construction team works on the final segment of tunnel HC1-02 at the An Phu Intersection project in Ho Chi Minh City. Photo: Chau Tuan / Tuoi Tre

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 6.

A construction site is cluttered with materials and scattered concrete piles at An Phu Intersection in Ho Chi Minh City. Photo: Duc Phu / Tuoi Tre

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 7.

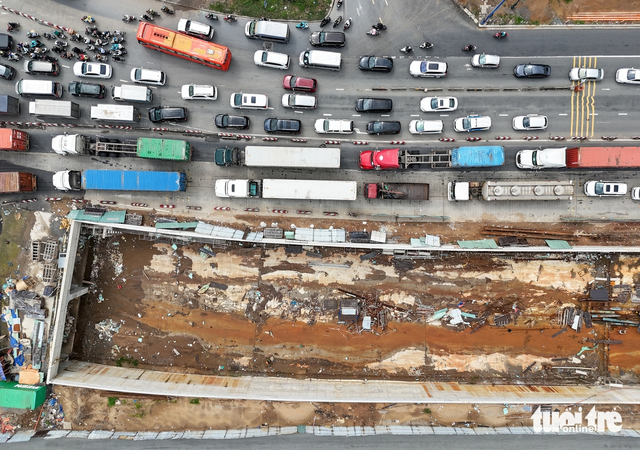

This area belongs to package XL12, which has reached only about 15-percent progress, at the An Phu Intersection project in Ho Chi Minh City. Photo: Duc Phu / Tuoi Tre

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 8.

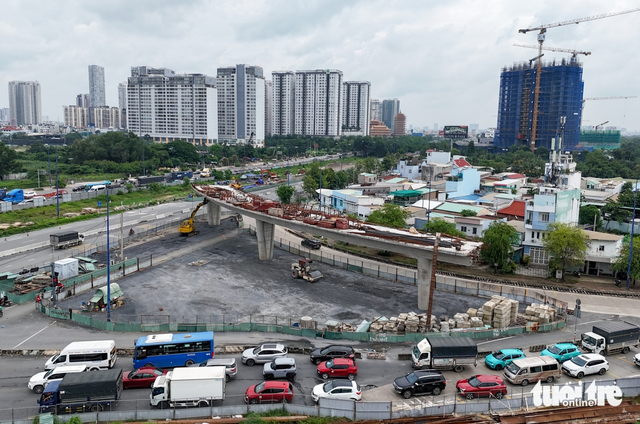

Also part of package XL12, the overpass branch connecting to Luong Dinh Cua Street at the An Phu Intersection project in Ho Chi Minh City currently has only a few overpass piers completed, with much of the site not being cleared. Photo: Chau Tuan / Tuoi Tre

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 9.
Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 10.
Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 11.

From above, many parts of the An Phu Intersection in Ho Chi Minh City remain disconnected, interspersed with inactive zones and sparse worker presence.

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 12.

The Ba Dat Bridge component on the Ho Chi Minh City - Long Thanh - Dau Giay Expressway ramp has been completed but cannot be opened to traffic as other structures at the An Phu Intersection project in Ho Chi Minh City remain unfinished. Photo: Duc Phu / Tuoi Tre

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 13.

A section of tunnel HC1-01 at the An Phu Intersection project in Ho Chi Minh City has its structure completed but remains unused due to the incomplete pumping station. Photo: Chau Tuan / Tuoi Tre

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 14.

A pier of the N2 overpass, the right-turn branch from the Ho Chi Minh City-Long Thanh-Dau Giay Expressway ramp to Mai Chi Tho Avenue is under construction in Ho Chi Minh City. Photo: Chau Tuan / Tuoi Tre

Slow progress at An Phu Intersection project in Ho Chi Minh City despite 6-month deadline- Ảnh 15.

An Phu is a critically important traffic junction at the eastern gateway of Ho Chi Minh City, marking the start of the Ho Chi Minh City – Long Thanh – Dau Giay Expressway and connecting with Mai Chi Tho, Luong Dinh Cua, and Dong Van Cong Streets.

Thanh Ha - Chau Tuan - Duc Phu / Tuoi Tre News
