Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam

Following the proposal to shift international flights from Tan Son Nhat Airport in Ho Chi Minh City to Long Thanh Airport in neighboring Dong Nai Province, many have expressed concerns over potential traffic congestion due to underdeveloped infrastructure. Tuoi Tre has reviewed the current status of key national transportation projects connecting to Long Thanh Airport.

Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam

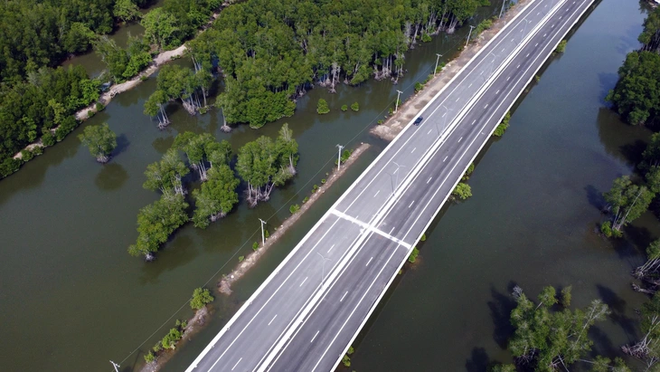

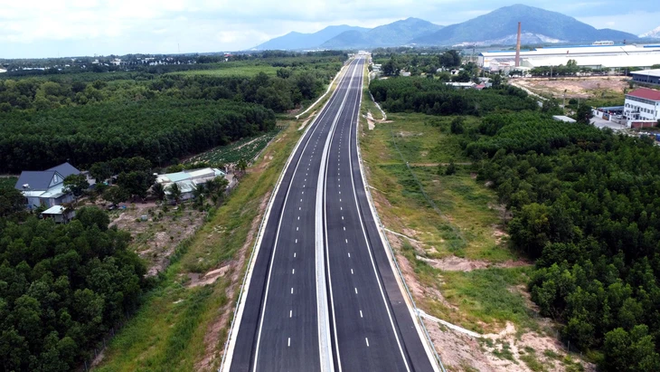

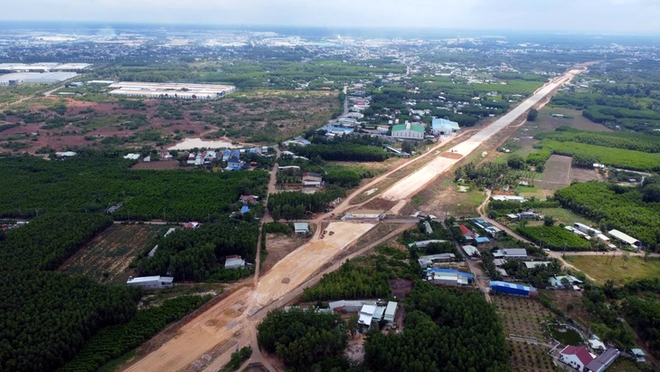

Road T1 linking Long Thanh Airport with Road T2, National Highway 51, and the Bien Hoa - Vung Tau Expressway has been completed. Photo: A Loc / Tuoi Tre

Among the current connection projects, Road T1 has been completed, while Road T2 is ahead of schedule and expected to be finished by September.

The two road projects were commenced on July 14, 2023 at a total cost of over VND2.63 trillion (US$100 million).

Road T1 is 4.3 kilometers long, while Road T2 has a length of 3.5 kilometers

Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 1.

Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 2.
Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 3.

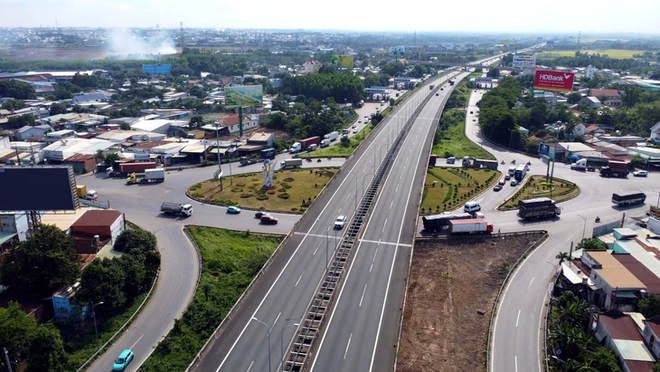

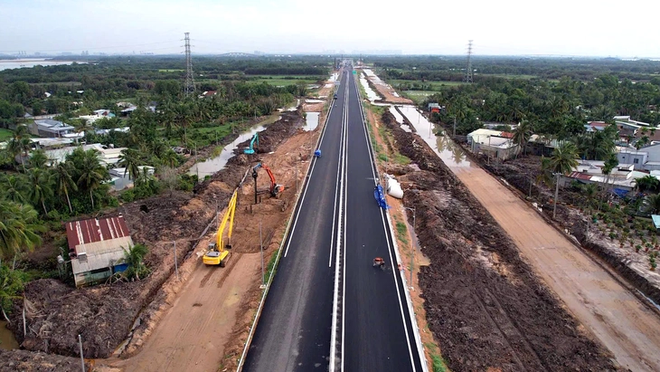

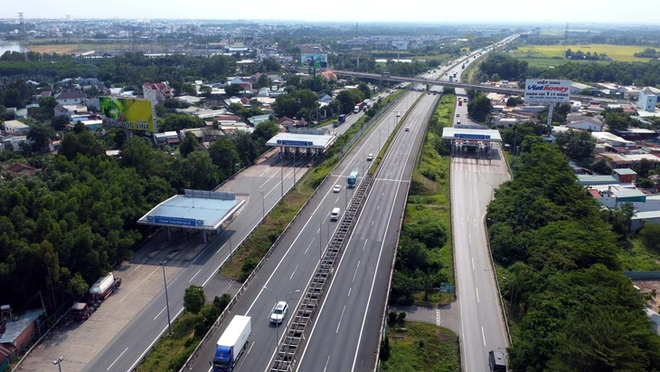

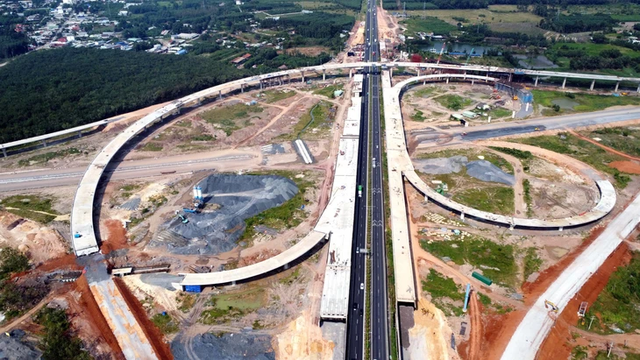

The Bien Hoa - Vung Tau Expressway spans 53.7 km through Dong Nai Province and the former Ba Ria - Vung Tau Province. Photo: Ha Mi / Tuoi Tre

However, the section of the Ben Luc - Long Thanh Expressway that connects to National Highway 51 remains incomplete.

While several overpass pillars have been constructed, progress is stalled due to pending land clearance in Phuoc Thai Commune, Dong Nai Province.

Dong Van Minh, a local resident whose land was reclaimed for the project, said he and several other households had received land acquisition notices but are still waiting for compensation.

Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 4.

Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 5.
Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 6.

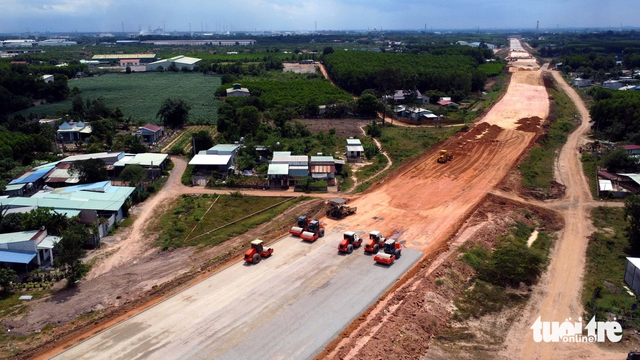

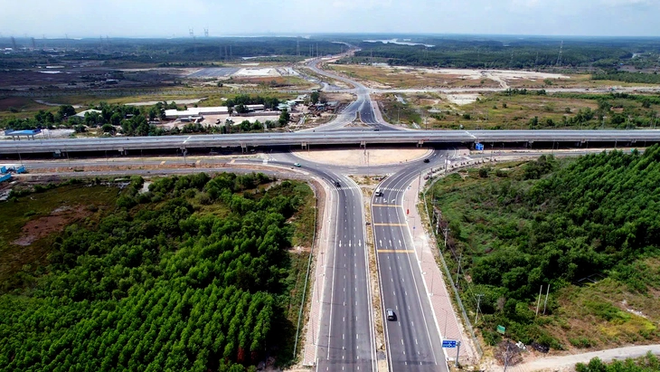

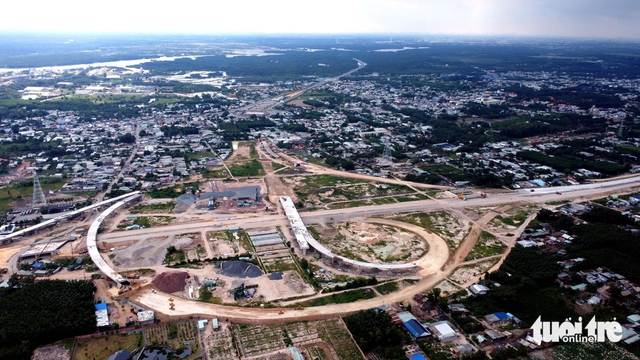

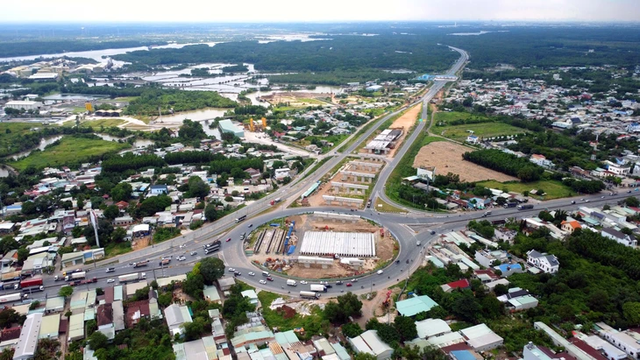

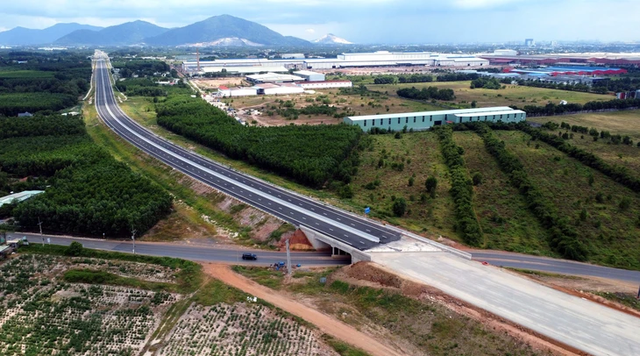

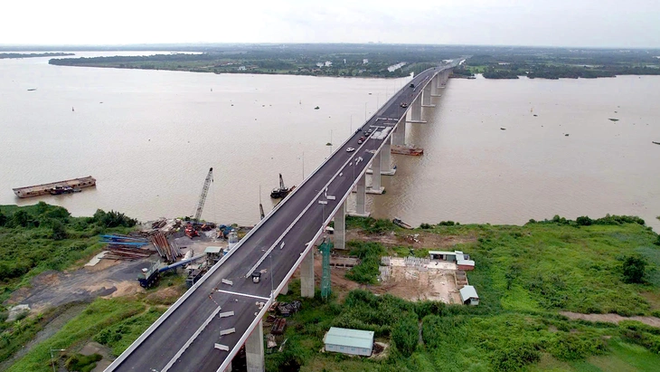

A portion of the Ben Luc - Long Thanh Expressway connecting to National Highway 51 has already been put into use. However, an additional 400-meter section linking Ben Luc - Long Thanh to the Bien Hoa - Vung Tau Expressway is still awaiting land clearance. Photo: A Loc / Tuoi Tre

In the Bien Hoa - Vung Tau Expressway section in Phuoc Thai Commune, Dong Nai Province, one side of the road has been paved while the other side is still undergoing groundwork.

On the Ho Chi Minh City - Long Thanh - Dau Giay Expressway, traffic occasionally slows down at the intersection with National Highway 51 due to heavy vehicle flow. The expressway expansion is set to begin on August 19 to alleviate congestion before Long Thanh Airport becomes operational.

In addition to this expressway expansion project, Long Thanh Airport is also planned to connect with several rail and road systems.

In particular, the North-South high-speed railway is expected to break ground in December 2026, and the Long Thanh - Thu Thiem railway is in the pre-feasibility study phase.

Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 7.

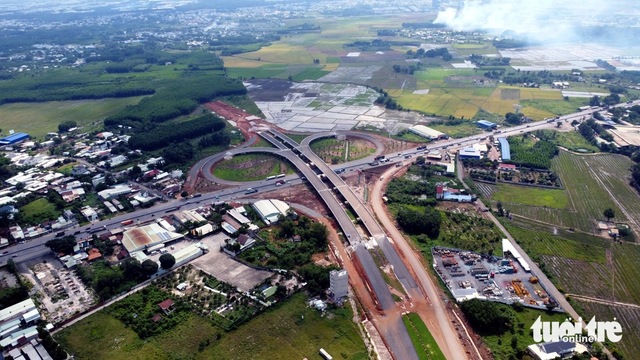

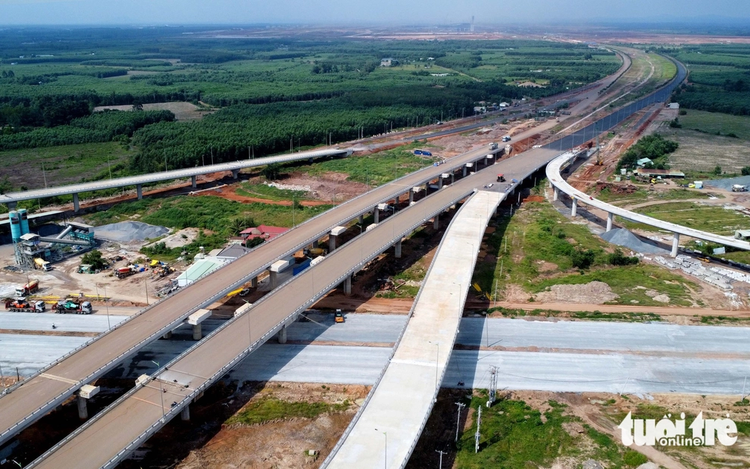

The land clearance for the section of the Ben Luc - Long Thanh Expressway through Dong Nai, totaling 34.2 km, has been resolved, and construction units are accelerating efforts to ensure the entire route becomes operational by 2026. Photo: A Loc / Tuoi Tre

Dong Nai Province is accelerating investment procedures for the extension of Ho Chi Minh City's Metro Line No. 1 to Long Thanh Airport, with an estimated investment of VND65 trillion ($2.5 billion).

In the future, the metro network is expected to become more interconnected as Ho Chi Minh City and Dong Nai adjust their urban planning under a new model and vision.

Long Thanh and Tan Son Nhat airports will eventually be linked via the Thu Thiem - Long Thanh railway and the expanded metro system of Ho Chi Minh City.

Other potential connections include Metro Line No. 3, planned to run from Vung Tau to Long Thanh Airport.

Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 8.

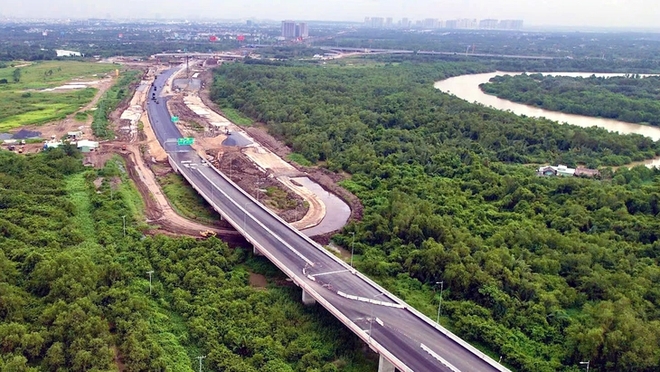

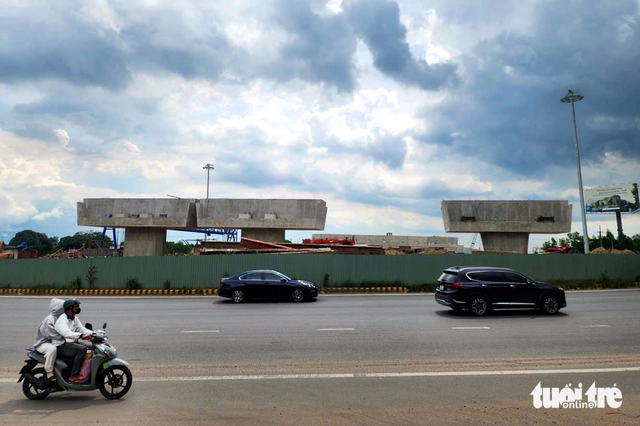

An interchange of the Bien Hoa - Vung Tau Expressway is gradually taking shape, although a short segment is still hindered by land clearance issues. Photo: Ha Mi / Tuoi Tre

Regarding the road network, in addition to the key ongoing projects, there are also plans for the nearly completed Beltway No. 3, elevated roads along National Highway 51 from Vung Tau Intersection to the Bien Hoa - Vung Tau Expressway, and the proposed Beltway No. 4 of Ho Chi Minh City.

The infrastructure framework connecting Long Thanh Airport is largely in place and under development. The remaining challenge lies in accelerating administrative procedures and construction to meet urgent transportation demands.

Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 9.

Bridge piers located along National Highway 51 are awaiting connection between the Ben Luc - Long Thanh Expressway and the Bien Hoa - Vung Tau Expressway. This area includes branch roads leading to Long Thanh Airport. Photo: Ha Mi / Tuoi Tre

Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 10.

The interchange between National Highway 51 and Road T1 linking to Long Thanh Airport has taken shape and is ready for operation when the airport becomes active. Photo: Ha Mi / Tuoi Tre

Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 11.
Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 12.

Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 13.

The Ho Chi Minh City - Long Thanh - Dau Giay Expressway connects to National Highway 51 and intersects with Road T2 and the Bien Hoa - Vung Tau Expressway. This is one of the main arteries linking downtown Ho Chi Minh City with Long Thanh Airport, and is set to be expanded to 8–10 lanes with groundbreaking scheduled for August 19, 2025. Photo: A Loc / Tuoi Tre

Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 14.
Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 15.
Status quo of transportation projects connecting Long Thanh Airport in southern Vietnam - Ảnh 16.

The Nhon Trach Bridge is basically complete and scheduled to open to traffic on August 19, 2025, helping to reduce congestion on the Ho Chi Minh City - Long Thanh - Dau Giay Expressway. It is also an important future link to Long Thanh Airport. Photo: A Loc / Tuoi Tre
